India's First Bullet Train: A Leap Towards Advanced Rail Connectivity

Marking a significant stride in India's railway network, the inaugural bullet train section in the country spanning 50km between Bilimora and Surat in Gujarat is slated for completion by August 2026, as articulated by Railways Minister Ashwini Vaishnaw.

This announcement was one amongst numerous initiatives unveiled by the minister aimed at transforming India's rail services and network.

The Kavach System

In the wake of an appalling railway collision in Balasore, Odisha, in June which claimed the lives of nearly 300 individuals, Vaishnaw highlighted the Kavach system. This homegrown warning system is designed to avert on-track collisions, thereby enhancing the safety of rail travel.

The minister also unveiled plans for the Gajraj system - a technology created to prevent collisions between elephants and trains, a frequent occurrence in certain regions of the country.

Expanding Rail Network

Vaishnaw further announced plans to construct additional railway tracks for improved connectivity across the country. He noted that the number of trains in India has surged post-pandemic.

The number of mail express services has risen from 1,768 to 2,124, while suburban services have increased from 5,626 to 5,774. The count of passenger trains has also elevated from 2,792 to 2,856. The Railways served 640 crore passengers in 2022-23, with the target set at 750 crore for 2023-24.

Progress On The Bullet Train Front

This announcement follows the minister's previous update where he stated that considerable progress had been made on the Mumbai-Ahmedabad bullet train corridor. This corridor, extending over 500km, includes the Bilimora-Surat section.

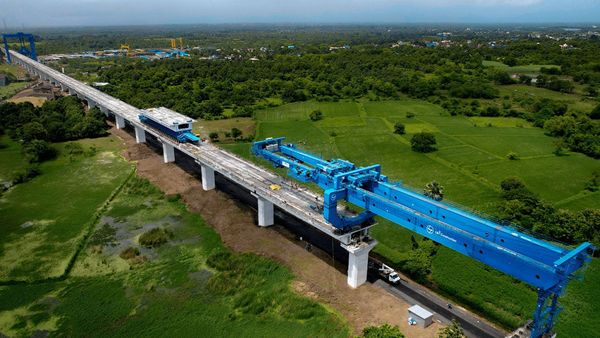

A significant milestone has been achieved with the completion of 100km of viaducts and 230km of pier work. These viaducts, essentially extended bridge-like structures supported by piers or towers, are instrumental in carrying railway tracks over valleys or gorges.

The minister shared visuals of the completed viaducts across the Valsad, Navsari, Surat, Vadodara, and Anand districts. Since work commenced in November 2021, the Mumbai-Ahmedabad corridor has been progressing steadily.

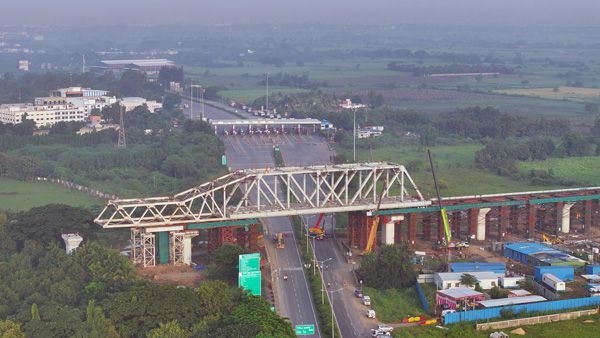

The first kilometre of the viaduct was completed in six months, and the 50th was achieved by April of the following year. Bridges are also being constructed over six rivers - Par and Auranga in Valsad district, and Purna, Mindhola, Ambika, and Venganiya in Navsari district as part of the corridor.

Funding For The Project

The National High-Speed Rail Corporation Limited (NHSRCL) shared drone footage of these bridges, some of which are already constructed. The estimated cost of the project is Rs 1.08 lakh crore.

The central government has pledged to contribute Rs 10,000 crore, while Gujarat and Maharashtra will each contribute Rs 5,000 crore. The rest of the funding will be procured through a loan from Japan at a nominal interest rate of 0.1 per cent.

In conclusion, these ambitious projects, spearheaded by Railways Minister Ashwini Vaishnaw, demonstrate a commitment to revolutionizing India's rail network. Through the introduction of the country's first bullet train, India is poised to set new benchmarks in rail connectivity and safety.
